How to use the Manual Billing Rule for Projects in Microsoft Dynamics AX 2012 R2 and AX2012 R3
This blog goes through the steps of setting up the Manual Billing Rule for Project.
Setup a Journal for Billing Rule Fee Journal – Project Management and Accounting | Setup | Project Management and Accounting Parameters
- Click the Journal link
- Select Billing Rule Fee Journal:
3. Close the form
Create a Project – Project Management and Accounting | Common | Projects | All Projects
- Click the Project button in the New group of the Project tab

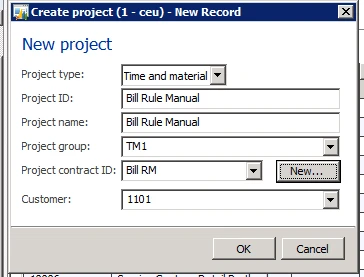

- Select the Project Type:
- Enter the Project ID:
- Enter the Project Name:
- Select the Project Group:
- Click the New button next to the Project Contract ID
- Enter the Project Contract ID:
- Enter the Name
- Select the Funding Type:
- Select the Funding Source:
- Click Ok
- Click Ok
- Click the Project Stage button in the Maintain group of the Project tab select In Process

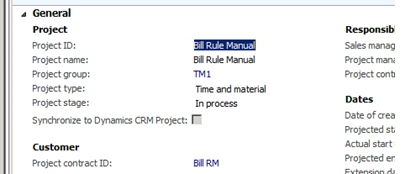

- Expand the General fast tab
- Click the Project Contract ID link

- Click the Billing Rule button in the Set up group of the Project Contract tab in AX 2012 R2 – *NOTE* – This was changed from a button to a fast tab in AX 2012 R3. Expand the Billing Rules fast tab.

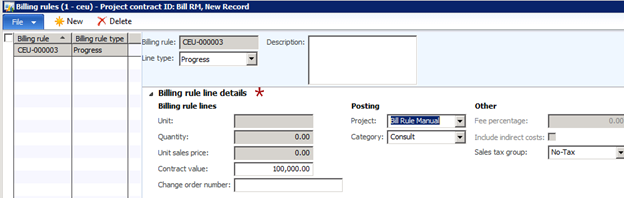

- Click the New button – AX 2012 R2 In AX 2012 R3 click the Add button
- Select the Line Type: Progress
- Enter the Contract Value:
- Select the Project you created
- Select the Category
- Close the Billing Rules form
- Click the Manage Contract Status button in the Process group of the Maintain group of the Project Contracts form

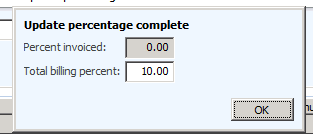

- Click the Update Percentage button and enter the Total Billing Percent
- Click Ok
- Note no changes to the form
- Close the Contract Status form

- Click the Project Invoice Proposal button in the Bill group of the Maintain tab of the Project Contract form

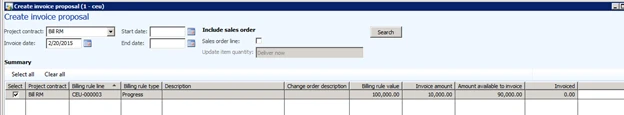

- Click the Invoice Proposal From Billing Rule button in the New group of the Invoice Proposal tab
- Select the Project Contract
- Click the Search button
- Mark the Select checkbox
- Click Ok
- Click the Post button in the Functions group of the Invoice Proposal tab of the Invoice Proposals form
- Click Ok
- Click Ok if prompted
- Close the Invoice Proposal form
- Click the Manage Contract Status button in the Process group of the Maintain group in the Project Contract form

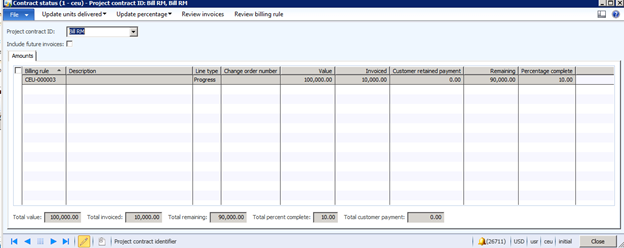

Note the changes in the Contract Status form.
Reference:
How to use the Automatic Billing Rule for Projects in Microsoft Dynamics AX 2012 R2 and AX2012 R3
