How General Budget Reservations will update Committed Cost on Project Contracts


This article will explain how to create a General Budget Reservation for tracking Committed Cost on a Project.

This article assumes that you have installed KB3047235 on an AX 2012 R3 CU8 environment and you are using public sector. It also assumes you have gone through all the initial setup required that are listed in MSDN article:  https://msdn.microsoft.com/en-us/dynamics/dn792460(v=ax.60)
or through blog: How to setup General Budget Reservation functionality that was added after AX 2012 R3 CU8 for Public Sector:  http://blogs.msdn.com/b/axsupport/archive/2015/05/26/how-to-setup-general-budget-reservation-functionality-that-was-added-after-ax-2012-r3-cu8-for-public-sector.aspx

In the Project Management and Accounting Parameters you will need to make sure to include General Budget Reservations with Committed Cost.  Project Management and Accounting | Setup | Project Management and Accounting Parameters

1. Click the Cost Control Option
2. Mark General Budget Reservation checkbox

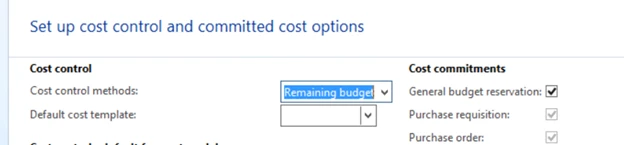

Set up cost control and committed cost options.

3. Close the form

Create a Budget Register Entry to track your budget – Budgeting | Common | Budget Register Entries | All Budget Register Entries – In the Budget Register Entry tab, in the New group, click the Budget Register Entry button.

1. Select your Budget Model
2. Select your Budget Code

Budget register entry transaction.

3. Click the Add Line button
4. Select the Account Structure
5. Enter the Dimension Values
6. Enter the Amount

Add line, select account structure, enter the dimension values and amount.

7. In the Budget Register Entry tab in the Update group click the Update Budget Balances button
8. Click Ok if prompted
9. Close the Infolog
10. Close the Budget Register Entry form

Create a new Project – Project Management and Accounting | Common | Projects | All Projects – In the Project tab in the New group click the Project button

1. Select the Project Type
2 Enter the Project Name
3. Select the Project Group
4. Select a Project Contract ID or Create a new one

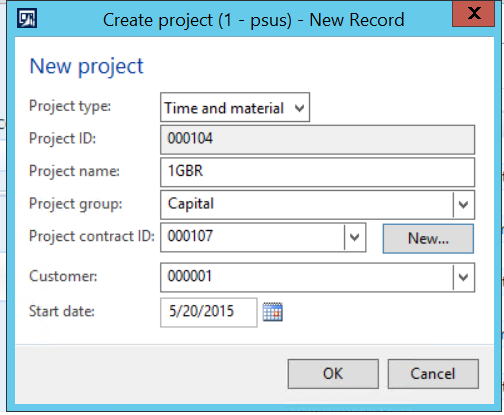

Select project type, project name, project group, project contract ID or create a new one.

5. Click Ok button
6. Click the Project Contract ID link
7. Expand the Funding Limits fast tab
8. Click the Add button
9. Select a Funding Source
10. Select a Project
11. Enter an Amount

Funding limits.

12. Close the Projects Contract form
13. In the Projects form in the Project tab in the Maintain group click the Project Stage button and select In Process
14. Click Ok if Prompted
15. Close the Project form

Create a General Budget Reservation to link to the Project you created – Budgeting | Common | General Budget Reservation | All General Budget Reservation – In the Budget Reservation tab in the New group click the Budget Reservation button

1. Select Reservation Type:  Make sure the reservation time is relieving on the PO
2. Enter Reservation Title
3. Enter the End date

Create a new general budget reservation.

4. Click Ok
5. Click the Add Line button
6. Enter the Transaction Text
7. Select the Project you created above
8. Change the Category if needed
9. Enter the Quantity
10. Enter the Unit Price

General budget reservation lines.

11. Expand the Line Detail fast tab
12. Select the General tab
13. Select the Procurement Category

Line details fast tab.

14. Click the Project tab
15. Select the Unit

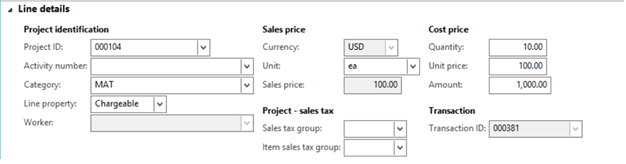

Project tab.

16. Save the record
17. Click the Distribute Amounts button
18. Verify the Ledger Account matches the Ledger Account matches the Budget Register Entry

Distribute amounts button.

19. In the Budget Reservation tab in the Post group click the Budget Reservation button
20. Close the Budget Reservation form

Go back to the Project Contract for this project.

Note the Committed Amount –

Funding limits.

In the Control tab in the Control group click the Committed Cost button.

You can see the General Budget Reservation has a cost amount.

General budget reservation cost amount.

If you click on the General tab you can see the General Budget Reservation that is linked.

General budget reservation that is linked.

Now create a Purchase Order for this project – In the Project form in the Manage tab in the New group click the Item Task button and select Purchase Order

1. Select the Vendor Account
2. Click Ok
3. Select the Procurement Category that was referenced above
4. Enter Quantity
5. Enter Unit
6. Enter Unit Price

Purchase order lines.

7. Expand the Line Details fast tab
8. Select the General Budget Reservation created above

Expanded line details fast tab.

9. Save the record
10. In the Purchase tab in the Generate group click the Confirm button

Now go back to the Project Contract, check the funding source and the Committed Cost form.

Note the Committed Amount does not change

Project contract funding source check.

In the Committed Cost form we can see there is a record for our Purchase Order and the Amount of Cost on the General Budget Reservation is reduced by the amount of the PO.

Committed cost form.

Now invoice part of the Purchase Order – In the Purchase Order form in the Invoice tab in the Generate group click the Invoice tab

11. Enter the Number
12. Change the Quantity to be less than the full amount

Purchase order form.

13. In the Vendor Invoice tab in the Actions group click the Post button

Go back to the Project Contract for the Project.

Note the Spent Amount is update and the Committed amount is reduced.

Vendor invoice tab.

The Cost Amount on the PO is reduced by the amount of the vendor invoice.

Cost amount on the purchase order.

The General Budget Reservation will hold the cost until it is relieved by the Purchase Order, which will then transfer the cost from the General Budget Reservation to the Purchase Order.
